Introduction
In 2025, Runwal Pinnacle stands tall, both literally and figuratively, as the most prominent high-rise project in Mulund West. But beneath its sheen, does Runwal Pinnacle Mulund West meet its promises—or is it lagging behind rival developments in the same neighbourhood? This legal review examines regulatory compliance, delivery timelines, project quality, comparative standing, and legal safeguards that are essential for homebuyers.
Let us help you find your perfect property! Click below to schedule a consultation.

Project Overview & Promises
- Location & Scale: Positioned strategically near Fortis Hospital and R Galleria Mall on Goregaon–Mulund Link Road, Runwal Pinnacle Mulund occupies about 2.25 acres and comprises a single 67‑storey tower offering 1, 2, and 3 BHK units

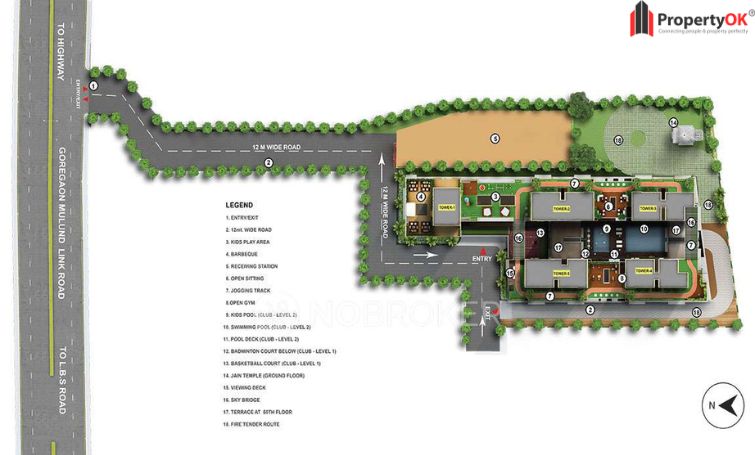

- Amenities: It aims to redefine urban living with sky-deck features, including a jogging track, sky gym, lounge, rooftop pool, badminton/tennis courts, clubhouse, mini-theatre, yoga and Zen gardens.
- Size & Pricing: Carpet areas range across:
- 1 BHK ~ 447–508 sq ft (₹1.17 Cr onwards)
- 2 BHK ~ 606–863 sq ft (₹1.47 Cr onwards)
- 3 BHK ~ 858–1,005 sq ft (₹2.21 Cr onwards)
At launch in mid‑2019, the Runwal Developer committed to possession by mid‑2026. However, legal and compliance updates reveal revisions extending timelines up to June 2027.

Regulatory Status & Legal Assurance
A cornerstone of any real estate legal review is the project’s compliance with RERA and related regulations:
- MahaRERA Registration: The project is registered under RERA as P51800021322, indicating formal regulatory recognition.
- Certificates: While the commencement certificate has been obtained, the occupancy certificate is still pending.
- Legal Complaints: There have been at least three RERA complaints filed, though specific grievances aren’t detailed in public portals.
- Litigation Flags: The RERA register mentions “Litigations,” hinting at potential disputes—buyers should review RERA filings for clarity.
Takeaway: While overall compliant, aspects like delayed OC and existing disputes require cautious due diligence. Prospective buyers should consult project stakeholders, RERA records, and legal counsel before moving forward.
Timeline: Promises vs Progress
- Original Timeline: June 2026 (per launch documents).
- Extended Deadline: Now pushing out to June 2027, nearly one year behind schedule.
Delays like these are, unfortunately, common in Mumbai, but buyers must verify compensation terms:
- RERA Interest: Developers must pay interest for delayed possession.
- Sale Deed Terms: Scrutinise clauses related to default, possession extension, and miscarriage terms.
- Loan Implications: Check mortgage timelines as lenders may revise loan drawdown schedules when occupancy certificates are pending.

Site Quality & Buyer Feedback
- Construction & Fit-Outs: Reviews highlight lavish specs—vitrified/marble flooring, modular kitchens, premium sanitary ware, video door phones, concealed wiring for smart home integration.
- Amenities Quality: Elevated parking (nine levels) and recreational facilities rank high. However, maintenance charges remain steep (e.g., ₹4,600–5,000 for 1 BHK).
- Buyer Sentiments: “Excellent place to live…connected to basic facilities…well‑structured infrastructure…best investment”.
Competitor Comparison: Is Pinnacle Falling Behind?
In Mulund West, Runwal Pinnacle competes with other towers like Sheth Montana, Oberoi Enigma, Wadhwa Atmosphere, Piramal Revanta, etc. A review of competing factors:
- Height & Skyline Dominance
Pinnacle’s 67 storeys make it the tallest in Mulund West, unmatched by peers like Sheth Montana (~60 storeys). - Amenities Edge
Sky‑decks and rooftop facilities grant it an upper hand over most competitor projects. - Connectivity & Infrastructure
- Proximate to upcoming Metro—Line 4 (~0.8 km) and Nahur Railway (~0.9 km).
- Connects via LBS Marg, Eastern Express Highway; comparable to rivals.
- Possession Timeline
Many other Mulund projects promise OC and keys by late 2025–early 2026. Pinnacle’s mid‑2027 schedule weighs it down. - Price Points
While on par with luxury rivals, the delayed delivery puts price competitiveness in question, especially when rental yield depends on possession.

Buyer Protection: Legal Strategies
For those still contemplating a unit at Runwal Pinnacle Mulund West, or reassessing investment in peer projects, here’s a quick legal guide:
Concern | Legal Safeguard |
Delays | Invoke RERA Section 18 for delay interest; check the sale agreement penalty clause. |
OC Status | Avoid taking possession without an occupancy certificate from the local authorities. |
Quality Disputes | Schedule site visits; retain third‑party surveyor reports (foundation, amenities). |
Legal Complaints & Litigations | Download RERA case history; request developer’s legal disclosures. |
Maintenance & Corpus Fund | Review projected annual budgets and fund allocation mechanisms. |
Title & Encumbrances | Confirm clean title via project lawyer; check for litigation on land parcels. |
Bank Loan Disbursement | Verify with the bank; ensure financing is not stalled due to pending OC. |
Check out our latest blog on Runwal Codename Enchanted – everything you need to know before you invest!
Runwal Codename Enchanted, Kolshet, Thane West: Top 10 Highlights of this Grand Project
In-Depth Regulatory Comparison: How Does Runwal Pinnacle Score Against RERA Benchmarks?
One of the biggest concerns among modern homebuyers is regulatory transparency. While Runwal Mulund West is MahaRERA registered, it’s essential to benchmark it against compliance trends in other Mulund West luxury projects.
Runwal Pinnacle’s Compliance Scorecard:
Criteria | Runwal Pinnacle | Peer Projects (Avg) |
MahaRERA Registration | ✅ P51800021322 | ✅ (Standard) |
Litigation Disclosures | ⚠️ 1+ Mentioned | ⚠️ 0–1 typically |
Construction Status (2025) | Superstructure completed | OC expected (some peers) |
Last Revised Possession Date | June 2027 | 2026 (avg.) |
Commencement Certificate | ✅ Obtained | ✅ Obtained |
Occupancy Certificate | ❌ Pending | ⚠️ Mixed status |
Legal Complaints (RERA) | 3+ found | 1–2 (avg.) |
Buyers should regularly check the MahaRERA portal for real-time project progress and complaints logged against Runwal Pinnacle Mulund.

Legal Clauses to Examine in Runwal Pinnacle Agreements
If you are buying or have already booked a flat in Runwal Pinnacle Mulund West, scrutinise the legal agreement for these important clauses:
1. Possession Date and Grace Period
- Look for the exact clause defining possession commitment.
- Note the grace period clause, often buried in fine print (typically 6–12 months extra).
- Ask if interest is payable during this period under RERA.
2. Penalty for Delay
- As per RERA Section 18, buyers are entitled to:
- Refund with interest, or
- Interest for every month of delay (currently ~9.5% p.a. in Maharashtra).
- Ensure this is reflected in your sale agreement.
3. Force Majeure Events
- COVID-19 may still be cited as a delay factor.
- Ensure these events are specifically defined and cannot be misused.
4. Defect Liability Clause
- As per RERA, the builder is liable for structural defects for 5 years.
- Make sure the clause isn’t restricted to workmanship only.
5. Escalation in Charges
- Many developers insert escalation clauses for:
- Floor rise
- Maintenance advance
- Clubhouse subscription
- Negotiate these before registration.
6. Termination and Refund Clause
- Understand refund timelines in case of cancellation or delayed delivery.
- Avoid clauses with vague language such as “reasonable time.”
Documents to Review Before Finalising a Unit
For legal due diligence in a high-value project like Runwal Pinnacle Mulund West, review the following documents:
- Copy of MahaRERA Registration Certificate
- Title Search Report (last 30 years)
- Commencement and IOD Certificate
- Draft Sale Agreement & Allotted Unit Details
- Legal Opinion from Developer’s Lawyer
- Encumbrance Certificate on Property
- Floor Plan Sanction Letter
- RERA Quarterly Updates
- Pending Litigations Report (MahaRERA + Consumer Forum)
- No Objection Certificates (NOCs) from civic bodies like BMC, Fire Dept., Pollution Board
Caution for NRIs and First-Time Buyers
For NRIs and first-time investors, legal clarity becomes doubly important:
- Check for FEMA compliance—are repatriation rights and property taxation clear?
- Confirm Power of Attorney (PoA) formats used for registration.
- Ensure TDS on property (1% for >₹50 lakh) is deducted and filed.
- Use Indian legal counsel to vet developer communications and changes in delivery dates.
Future Outlook: Will Runwal Pinnacle Regain Its Edge?
Despite concerns, Runwal Pinnacle Mulund West still enjoys potential upside. Here’s why:
Infrastructure Growth
- Metro Line 4 (Wadala–Kasarvadavali) will significantly boost Mulund’s connectivity by 2026.
- Goregaon–Mulund Link Road expansion may reduce travel time to Western suburbs.
Appreciation Potential
- Mulund West is showing steady price growth of ~6–8% annually.
- Once possession is granted, prices could appreciate by 10–15%, especially if interest rates stabilise.
Urban Migration
- With space saturation in Lower Parel and BKC, luxury high-rises in Mulund like Runwal Pinnacle Mulund are attracting working professionals and NRI investors.
Final Legal Checklist for Buyers
Before investing in Runwal Pinnacle (or similar projects), ensure:
- You have reviewed the MahaRERA registration and possession updates
- You understand the compensation mechanisms under RERA Section 18
- Your sale agreement has NO vague clauses on penalties
- You’ve physically visited the site and verified construction status
- You have compared resale and rental prospects with other towers
- You’ve taken legal counsel for agreement vetting and title checks

Final Verdict: Where Pinnacle Stands in 2025
- Strengths: Sky-high luxury, unbeatable amenities, rock-solid RERA compliance, and stellar connectivity.
- Weaknesses: Extended delivery timeline, pending occupancy certificate, premium maintenance, and water/parking issues.
Is Runwal Pinnacle falling behind competitors?
In terms of delivery schedule and OC readiness, it lags behind some peers. But in ambition, scale, and aspirational living appeal, it leads. Whether it outpaces rivals in financial and legal security depends on updated RERA filings, court outcomes on complaints, and whether the OC comes through soon.
Buyer Recommendations
- Verify Updated OC Status: Ask the builder for the Occupancy Certificate estimate; check with MUDA/MCD records.
- Check RERA Case Updates: Regularly monitor the project page and dispute outcomes.
- Re‑negotiate Terms: If extending possession beyond Jun 2027, get the builder to contractually cap interest/penalties.
- Get Surveyor Reports: Independent quality checks (foundation, plumbing, security).
- Legal Review: Engage a qualified real estate lawyer to vet the agreement, title, and clause fairness.
- Loan Monitoring: Confirm bank continues sanction; discuss extended disbursement timelines.
Check out our latest blog on Runwal Reserve Mumbai Resale Value
Runwal Reserve Mumbai Resale Value: Will Your Investment Hold Up?
Conclusion
Runwal Pinnacle represent architectural ambition and premium aspirations. To its credit, the project is RERA‑registered, location-savvy, and still unmatched in height and features in Mulund West. However, extended timelines, OC delays, and emerging complaints signal caution.
For a legal-minded buyer in 2025, the deciding factors lie in hard documents: updated RERA logs, OC timelines, delay compensation structure, and independent quality validation. If the developer delivers as per the renegotiated timeline and buyer protections are enforced, Runwal Pinnacle Mulund can still emerge as a crown jewel rather than a cautionary tale.
Frequently Asked Questions
- Are there any legal issues or past disputes with Runwal Pinnacle?
No active litigations are pending against Runwal Pinnacle; however, the developer’s record includes delays and consumer grievances in other projects, necessitating cautious legal due diligence.
- Is it safe to invest in Runwal Pinnacle Mulund in 2025?
Yes, but only after verifying title documents, construction approvals, and ensuring clauses for delay penalties and refunds are mentioned in the agreement.
- What is the current status of Runwal Pinnacle Mulund in 2025?
As of 2025, Runwal Pinnacle Mulund is under construction with revised possession timelines pushed to mid-2027. Completion delays and pending Occupancy Certificate have raised buyer concerns.
Disclaimer: The information presented in this blog is based on insights from real estate professionals and data sourced from reliable and publicly available platforms. While we strive to ensure the content is accurate and current, we do not guarantee its completeness or accuracy. This content is intended for informational purposes only and should not be construed as legal, financial, or professional advice. We disclaim any liability for errors, omissions, or outcomes from using this information. Readers are strongly advised to conduct their due diligence and consult with qualified experts before making any real estate investment or purchase decisions.
